You're probably in the middle of a budget review right now. A site team needs an excavator, drill rig, crusher, or dozer moved. Someone has measured the route, multiplied by a rough per-kilometre figure, and the transport quote that comes back is nowhere near that estimate.
That shock is common in heavy haulage. Standard freight logic breaks down fast once machinery size, route access, permits, and site conditions enter the picture. In Australia, that gap is even wider because long distances, uneven freight density, and strict oversize compliance rules all affect what a carrier can do on the road.
The practical way to read heavy equipment transport rates is to stop thinking of them as a simple mileage charge. They're a project cost. The truck is only one part of it. The route, legal access, loading method, trailer choice, waiting time, escorts, and paperwork often shape the quote more than the linehaul itself.
Table of Contents
- Why Your Heavy Equipment Quote Is More Than Just Kilometres
- The Core Components of a Transport Quote
- Key Cost Drivers That Determine Your Base Rate
- Decoding Surcharges and Accessory Fees
- Example Heavy Equipment Transport Rates for 2026
- How to Secure Accurate Quotes and Reduce Costs
- Navigating International Heavy Equipment Shipments
Why Your Heavy Equipment Quote Is More Than Just Kilometres
A project manager gets a price to move a 32-tonne excavator 180 kilometres and assumes the rate should be straightforward. Then the quote comes back higher than expected, not because the truck is covering more road, but because the move needs oversize permits, a pilot vehicle, a specific travel window, and a route that avoids weak structures and tight town access. That is how heavy haulage pricing works in practice.
Distance still matters. It just stops being the main story once the machine falls outside standard freight limits.
For heavy equipment, the carrier is pricing the whole operating task. That includes whether the load can travel under normal access, whether the route crosses state or council requirements, whether escorts are required, and whether pickup and delivery sites are workable for a low loader. In Australia, those controls are built around heavy vehicle access and permit rules set through the National Heavy Vehicle Regulator, which explains why route approval and operating conditions can change the cost of a job before the truck even leaves the yard, as outlined by the NHVR access permit framework.
That is why a short move can still be expensive.
A 90-kilometre job with permit administration, escort bookings, after-hours travel conditions, and time on site can cost more than a longer move that stays within standard dimensions and runs depot to depot. The fixed compliance work does not shrink much on short hauls. The truck still has to be positioned. The machine still has to be measured, loaded, secured, and checked against route conditions. If the load needs an approved path or restricted travel times, those costs sit in the quote whether the job is 50 kilometres or 500.
The first pricing gap usually shows up in four places:
- Oversize classification. Width, height, gross mass, attachments, blade position, bucket fitment, and boom rest position can push the load into a different permit and escort category.
- Route approvals. A route that looks direct on a map may be unusable because of bridge limits, local road controls, roundabout geometry, rail crossings, or council restrictions.
- Travel conditions. Curfews, daylight-only movement, school zone limits, weekend restrictions, and weather-related controls all affect truck utilisation and labour time.
- Site reality. Soft ground, poor turning space, no loading ramp, blocked laydown area, or no safe place to unchain can turn a simple move into a half-day operation.
This is the part many buyers miss. A heavy haulage quote is often a compliance and access quote with transport attached, not a simple per-kilometre charge.
If a price looks high, ask what approvals, escorts, route limits, and site assumptions are built into it. That question usually tells you more than the rate itself.

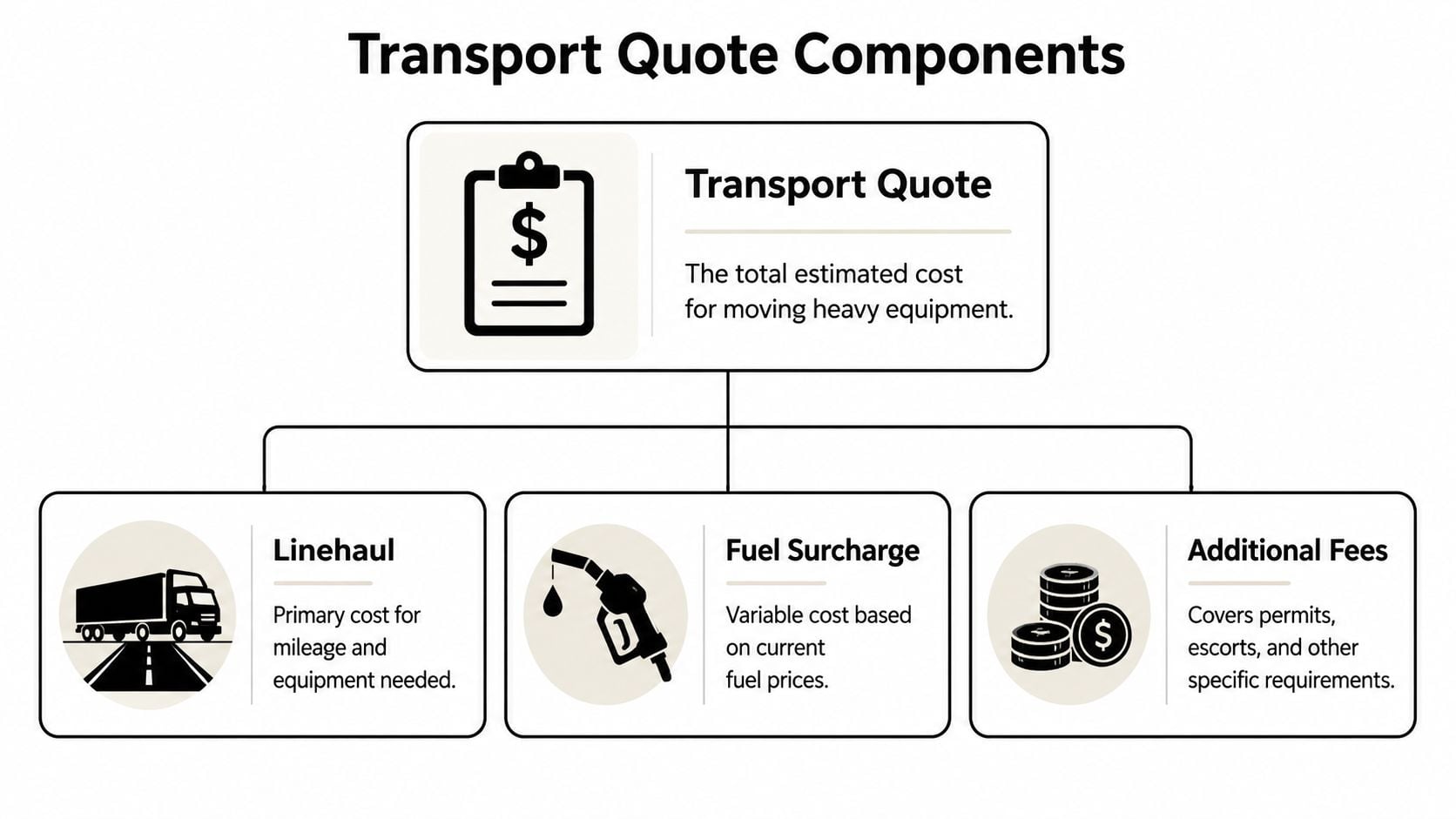

The Core Components of a Transport Quote
A proper heavy haul quote is built in layers, and the cheapest-looking line is often not the part that decides the final invoice. For machinery moves in Australia, the quote usually breaks into three buckets: linehaul, fuel and labour, and accessorial or compliance charges.

That structure matters because buyers often compare only the transport line and miss the fixed work wrapped around it. On a standard freight job, kilometres do most of the pricing. On a heavy equipment move, permits, escorts, route checks, loading conditions, and waiting time can carry more weight than the distance itself.
Linehaul is the truck, trailer, and allocation cost
Linehaul is the base charge for supplying the prime mover and the right trailer for the job, then running that combination over the approved route. It covers the equipment allocation, the driver, the planned transit, and the carrier margin.
Trailer choice changes this number fast. A low loader, widening deck, drop deck, or multi-axle platform costs more to supply and ties up more specialised gear than a standard trailer. If the carrier has to reposition that trailer from another depot or from a previous job, that empty leg is part of the actual job cost as well.
For some moves, linehaul also reflects whether the carrier can reload nearby after delivery. Busy interstate corridors are easier to price sharply. Regional mine sites, remote civil projects, and one-way corridors usually are not.
Fuel and labour move with the job conditions
Fuel is commonly shown as a separate surcharge or as a variable allowance inside the rate. That makes sense because diesel shifts over time and heavy combinations burn more than general freight equipment.
Labour needs a closer look. The quote is not paying only for steering time. It may include loading supervision, chaining and restraint checks, waiting on site induction, escort coordination, and time lost while a machine is made ready for transport position.
A machine that drives straight onto the trailer at a clean depot is one job. A non-runner sitting on soft ground behind a half-built laydown yard is another.
Practical rule: If a quote looks light on fuel, labour, or waiting allowances, ask what assumptions were made about site readiness, machine condition, and loading method.
Additional fees often decide whether the quote is realistic
This is the part project teams need to read closely. Additional fees can include permits, pilot vehicles, police escorts in restricted cases, route surveys, bridge assessments, traffic control, after-hours access, crane or loading support, and detention if the truck is held up on site.
Those items are not padding. They exist because the move has to comply with road access rules and arrive without creating a safety or legal problem. A shorter haul with two permits and an escort can cost more than a longer unrestricted run for that reason.
The same logic applies when the move changes mode. If the machinery is heading offshore or arriving by sea, the inland quote can sit alongside port handling, wharf timing, and lift planning through break bulk cargo services for oversized machinery.
Read the accessory section line by line. If the quote does not spell out approvals, escort requirements, loading responsibility, and waiting time, the price may still be incomplete.
Key Cost Drivers That Determine Your Base Rate
The base rate starts with the machine itself. Not the project value, not the urgency, not how often you use that lane. The carrier first wants to know exactly what the machine is, how large it is in transport position, and what it weighs in real operating condition.

Under Australia's compliance framework, pricing changes sharply once a load is classed as oversize or overmass. The NHVR-based rules summarised in this guide to heavy equipment shipping costs note that loads exceeding standard dimensions can require route-specific permits and pilot vehicles. That's why a shorter restricted move can cost more per kilometre than a long highway run.
Machine dimensions change the whole job
Weight matters, but dimensions often trigger the bigger shift. Height determines whether the machine can stay on a certain trailer and still clear the route. Width affects escort requirements and route choice. Length can affect turning paths and access at both ends.
Common quote failures happen when the shipper provides machine model only and assumes the carrier will know the precise dimensions. That's risky. The same excavator model can present differently with bucket fitted, stick position changed, guarding installed, or aftermarket attachments left on.
A better approach is to provide:
- Transport dimensions: Length, width, height, and gross weight in travel condition
- Attachments listed separately: Bucket, blade, ripper, auger, forks, or any removable components
- Operating condition: Running, non-running, or requiring external lifting assistance
If the machine can be partially dismantled without disrupting the project, that can change the transport class and open cheaper trailer options. It won't always be worth it, but it's one of the few genuine levers a shipper can control.
Route shape matters more than map distance
A clean motorway lane is not the same as a metro pickup with school-zone restrictions, overhead constraints, and a delivery site that needs off-street reversing. Two jobs with similar kilometre counts can have very different base rates because the route difficulty is different from the first hour.
This is also where a break bulk or project cargo mindset helps. Teams moving large industrial pieces often plan the route and handling method before they compare carriers. That's the right sequence. If your move sits outside standard freight parameters, break bulk cargo services give a useful reference point for how non-containerised loads are assessed operationally.
Urgency narrows your options
Last-minute bookings don't just raise price because carriers want a premium. They raise price because fewer legal and practical options remain. The right trailer may already be committed. Escort bookings may be tight. The preferred travel window may be gone. Site loading might then need to happen outside the most efficient sequence.
If you can't be flexible on timing, be precise on everything else. Exact dimensions, addresses, and site conditions become even more important when the booking window is tight.
Urgency pricing is really option scarcity. Plan earlier and you'll usually get more realistic heavy equipment transport rates, better equipment matching, and fewer late quote revisions.
Decoding Surcharges and Accessory Fees
Most quote shock sits in this part of the invoice. These charges get called hidden fees, but in practice they're usually visible consequences of a difficult move. The trouble is that many first-pass estimates don't include them in enough detail.
In Australia, compliance overhead can outweigh distance costs. For OSOM movements, route-specific permits, pilot vehicles, curfews, and state-by-state approvals can cause two jobs with the same kilometre count to price very differently, as outlined in this heavy haul cost calculation guide. That's why a basic per-kilometre estimate often falls apart once the load is checked properly.
Compliance items that are often mistaken for extras
These aren't optional upgrades. They're usually triggered by the load profile or route conditions.
- Permits: A route-specific permit is often required once dimensions or mass exceed standard limits. The carrier has to confirm legal access, approved roads, and any travel conditions attached to the permit.
- Pilot or escort vehicles: These are mandatory on some oversized movements. Their cost includes not only the vehicle itself but also scheduling, coordination, and time on task.
- Curfew and travel-window management: Some loads can't move freely through peak periods, urban areas, or certain corridors at certain times. That restriction can create waiting time and split a journey into less efficient stages.
- Jurisdictional approvals: Interstate work adds another layer because approval pathways and access conditions can differ by state.
One practical takeaway is simple. If a quote says “permits if required” or “escort if required” without any attempt to define likely triggers, the quote may still be too early to rely on.
Site and handling charges that catch people out
The road leg gets most of the attention, but the pickup and delivery sites often create the expensive variations.
A few recurring examples:
| Fee type | What triggers it | Why it matters |
|---|---|---|
| Loading support | No ramp, no self-loading ability, or restricted access | The carrier may need cranes, forklifts, riggers, or extra labour |
| Waiting time | Machine not ready, operator unavailable, paperwork incomplete | A specialised truck standing idle is still costing money |
| Detention at delivery | Site blocked, induction delay, no receiver present | Delivery windows can collapse and affect the next booked job |
| Liability uplift | High-value machinery or unusual risk profile | Some operators will require clearer liability terms before moving |
Insurance deserves attention here too. Basic carrier liability and project-level risk expectations aren't always aligned, especially for specialised plant. If the machine value is high or the project is delay-sensitive, it's worth reviewing cargo liability coverage options before you assume the transport line item is enough.
A quote that itemises likely accessory costs is usually more useful than a cheaper quote that leaves them vague.
Good operators don't hide these costs. They expose them early so you can decide whether to change the machine setup, route timing, or site preparation before locking in the move.
Example Heavy Equipment Transport Rates for 2026
A project manager approves a move based on kilometres, then the quote lands and the actual cost sits in permits, escorts, curfews, route checks, and trailer choice. That happens all the time in Australian heavy haulage. Distance still matters, but on many oversize moves it stops being the main number.
Use the examples below as budget ranges, not fixed tariffs. They reflect the way carriers price heavy plant in 2026. The machine profile, compliance burden, and access conditions usually move the quote more than a simple per-kilometre formula.
Estimated 2026 heavy equipment transport rates in Australia
| Equipment Type (Approx. Weight) | Route (Approx. Distance) | Estimated Cost Range (AUD) | Key Assumptions |
|---|---|---|---|
| Excavator (approx. 20-tonne) | Metro or regional short haul (approx. 50 to 150 km) | $2,500 to $4,500 | Assumes standard low loader, no major permit issue, bucket secured or removed if needed. Price rises if width, transport height, or late booking creates escort or route restrictions |
| Bulldozer (approx. D6 class) | Inter-capital lane (approx. 500 to 900 km) | $8,000 to $15,000 | Assumes low-loader or drop-deck heavy haul setup. Blade configuration, overall width, and state permit processing can shift the job toward the top of the range |
| Agricultural harvester or oversized farm machine | Regional to interstate move (approx. 300 to 1,000 km) | $7,500 to $16,000 | Assumes seasonal demand, possible pilot vehicle requirement, and some disassembly. Harvest timing and road access windows often push pricing up fast |
| Large crusher component or mining plant item | Long-haul remote corridor (approx. 800 to 2,000 km) | $18,000 to $45,000+ | Assumes specialised trailer selection, route survey, permit coordination, and remote delivery conditions. Remote fuel, escort coverage, and compliance planning often dominate the total |
| Non-running machinery | Any route | $3,500 to $20,000+ | Assumes loading and unloading require winching, cranes, skates, or other site support. Final price depends heavily on weight, dimensions, and whether the machine can be safely recovered onto the trailer |
How to read these examples properly
The spread matters as much as the headline number. A 20-tonne excavator can be a straightforward half-day move, or it can become a permit job with attachment handling, restricted delivery hours, and a wasted slot if the site is not ready.
For budgeting, check four things before treating the lower end of any range as realistic:
- Transport dimensions in travel configuration. Height and width often decide whether the job stays routine or moves into permit territory.
- Route and jurisdiction changes. Crossing state lines or entering metro restricted zones can add approval time, escort requirements, and tighter delivery windows.
- Loadability. A running machine that can self-load is cheaper to move than dead plant that needs recovery gear or crane support.
- Compliance visibility. The better the machine and route information, the less risk pricing gets built into the quote.
On higher-value fleets, operators also factor in tracking expectations, delivery control, and chain-of-responsibility discipline. That is one reason some project teams review Evright Industrial's best practices before sending out RFQs. Better asset data usually produces cleaner pricing.
How to Secure Accurate Quotes and Reduce Costs
Most expensive transport mistakes happen before anyone accepts the quote. They start with missing dimensions, unclear addresses, or assumptions that the carrier will “work it out on the day”. In the current market, that's a bad habit. Cost pressure in heavy haulage has become more sensitive to compliance and logistics complexity, not just mileage, which is why recent freight market commentary makes the case for precise, all-inclusive quoting.
What to send with every RFQ
A good RFQ gives the carrier enough information to commit to a realistic price. A weak RFQ produces either a padded quote or a cheap quote that changes later.
Send these details every time:
- Exact machine dimensions and weight: Don't rely on brochure specs if attachments or guarding have changed the profile.
- Photos from multiple angles: Include front, rear, both sides, and close-ups of anything that affects loading.
- Pickup and delivery addresses: Actual site locations matter more than suburb names.
- Site access notes: Gate width, surface condition, slope, turning room, induction rules, and any time restrictions.
- Loading method: Can it drive on, be winched, or does it need a crane or forklift?
- Required dates: Give preferred timing and your acceptable window, not just one hard date if flexibility exists.
If you manage multiple assets, the admin side matters too. Clean identification records reduce avoidable mistakes around the wrong unit, wrong attachment set, or missing compliance paperwork. That's where Evright Industrial's best practices are useful. Their guidance on asset tracking supports the handover discipline that transport jobs need.
What actually lowers the final invoice
A lot of cost-saving advice in freight is generic. In heavy machinery moves, the wins are practical and specific.
First, reduce the transport profile if you can. Removing buckets, booms, blades, guards, or wide attachments can shift the move into a simpler trailer and permit category. You'll need to compare the workshop time against the transport savings, but it's often worth checking.
Second, prepare the sites properly. Carriers lose time when they arrive to find boggy ground, blocked access, missing lifting gear, or no one authorised to release the machine. Time lost on a specialised truck is expensive because that asset was scheduled for a sequence of jobs, not just yours.
Third, book earlier than feels necessary. Early notice gives the carrier a chance to match the right trailer, stage permits sensibly, and build your load into an efficient plan rather than an emergency one.
The cheapest move is often the one that becomes simpler before the truck arrives.
If you want comparable quotes, insist that each carrier price the same scope. Same machine dimensions. Same access assumptions. Same loading method. Same likely compliance pathway. Otherwise, you're not comparing heavy equipment transport rates. You're comparing different interpretations of the same problem.

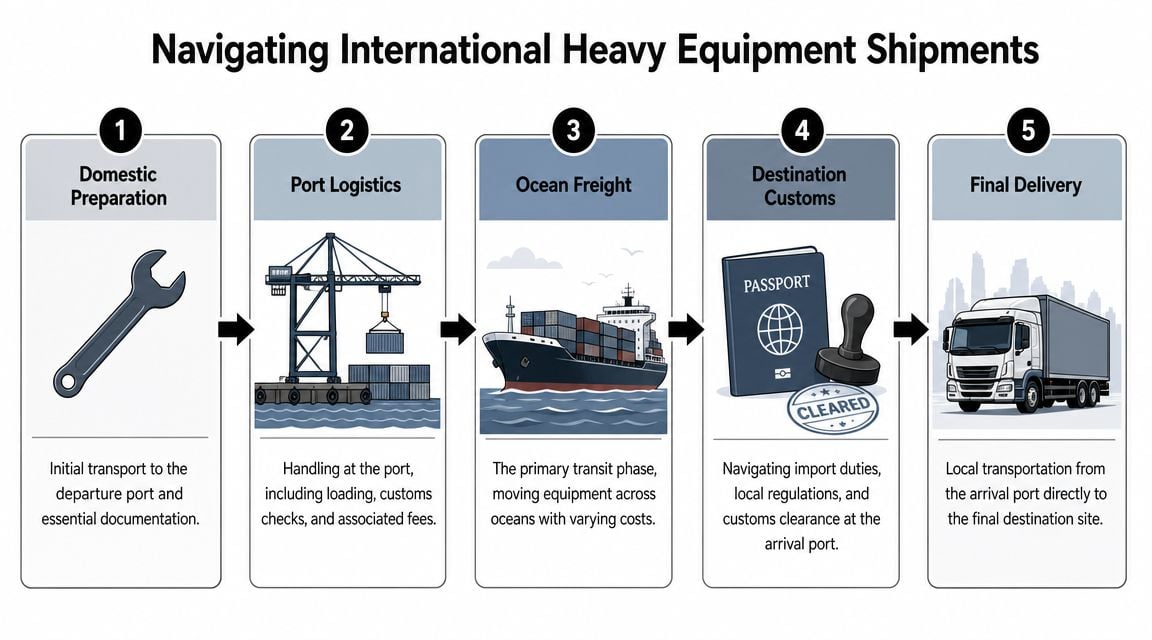

Navigating International Heavy Equipment Shipments
Domestic heavy haulage is already a coordination exercise. International machinery shipping adds another layer at every handoff. The machine still has to get from site to port. Then it has to clear export handling, ocean freight, arrival formalities, destination handling, and inland delivery at the far end.

Where international moves become expensive
The domestic rate is only one layer of the total landed cost. International shipments can involve dismantling, lashing, blocking, bracing, port receival cut-offs, customs documentation, quarantine attention, and final-mile delivery planning after discharge.
A few decisions carry outsized consequences:
- Shipping method selection: RoRo, break bulk, flat rack, and containerisation each suit different machinery profiles.
- Port handling exposure: Some equipment is simple to roll on and off. Other units need lifting plans, port equipment, or special handling arrangements.
- Documentation quality: A small error in cargo description, packing details, or ownership paperwork can stall the shipment at a costly point.
- Destination conditions: Import rules, local road permits, and final delivery access all need checking before the machine leaves Australia.
For larger or awkward units, project cargo handling is often the right operational lens because it treats the move as an end-to-end logistics job rather than a basic booking.
Why one coordinator matters
International machinery moves fail when too many parties optimise only their own segment. The carrier focuses on pickup. The port focuses on receival. The ocean line focuses on vessel cut-off. Customs focuses on paperwork. The site team just wants the machine delivered. If no one owns the whole chain, small errors stack up.
That's why a single coordinating freight partner matters on cross-border moves. The useful role isn't just booking sea space. It's aligning domestic pickup, dismantling if needed, packing method, port timing, customs requirements, and final delivery so the machine doesn't sit idle between steps.
Surely we can assist when the shipment involves that level of coordination, especially where oversized equipment, export handling, and final-mile planning need to run as one managed workflow.
A complex machinery move is easier to control when one team coordinates the road leg, export planning, sea freight, customs, and final delivery together. If you need practical support with oversized equipment, project cargo, or international heavy machinery shipping, AUSFF surely we can assist.
